Thinking about setting up your own BSL-2 lab in Singapore? It's a huge step. While having total control to test, build and operate on your own terms; expand capacity as needed; and safeguard your IP is exciting, the reality can be a heavy lift—especially for a young company. This article unpacks the real costs and key considerations of building and running a BSL-2 lab, helping you decide if you're ready to take the plunge. We'll also cover some smart alternatives if you're not quite there yet.
Insights
What to Know Before Building & Operating a BSL-2 Lab in Singapore
Date:
5 Oct 2025 7 minCategory:
InfrastructureWhere to Start: Location & Lab Size
Before you even think about equipment or costs, the first decision you'll make is where to set up your lab and how much space you'll need. In Singapore, most life sciences and biotech startup are clustered at One-North (Biopolis and Fusionopolis) and Singapore Science Park.
The smallest practical lab unit available for tenancy is typically around 2,500 sq ft, with options to scale up to 5,000–6,000 sq ft.
Here’s a look at typical unit sizes in these key hubs:
- Biopolis: modules range from around 1,500 to 3,000 sq ft, with full floors offering around 8,000–12,000 sq ft
- Fusionopolis: R&D blocks with wet-lab provisions, commonly available in 2,000–5,000 sq ft subdivisions
- Singapore Science Park: “wet-lab ready” units, which can be easily converted from office to lab use, range from around 2,500–3,500 sq ft units (given the mechanical ventilation and shaft specifications for exhaust); with full floors up to 20,000 sq ft

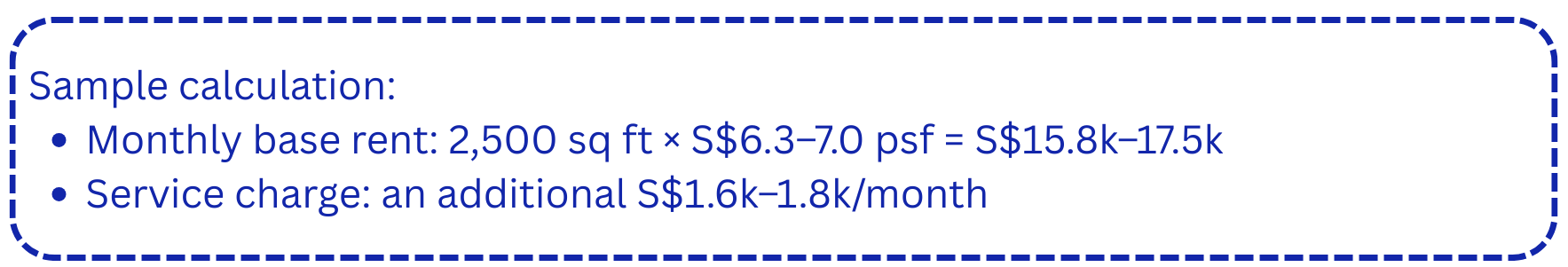

Rental rates in One-North and Singapore Science Park average around S$6.35 per square foot (psf) per month (as of Q1 2025). Keep in mind that bare units (without ducting, false ceilings, or raised flooring) are cheaper, but landlords often add service charges (~10% of base rent) for waste disposal and amenities. Leases typically run 2 years or more, with deposits pegged at one month’s rent per lease year.
Biosafety Levels: What They Mean for Your Lab
Biosafety levels (BSLs) are safety standards for labs working with biological agents. In Singapore, the facility requirements for working with different agents are governed by the Ministry of Health’s Biological Agents and Toxins Act (BATA).
| Biosafety Level | Suitable for | Requirements |
|---|---|---|
BSL-1 | Non-hazardous microbes | Basic hygiene only |
| BSL-2 | Moderate-risk pathogens | BSCs, restricted access, autoclave |
| BSL-3 | Serious airborne pathogens | Negative pressure, HEPA filtration, certification by MOH-approved body |
For this article, all estimates below are based on a BSL-2 lab.
Capital Expenditure (CapEx): Build-up Costs
The biggest share of CapEx comes from wet-lab fit-out (construction), typically S$300–600 psf or S$750k–1.5m for a 2,500 sq ft space.
Most of this is driven by mechanical and engineering (M&E) works and basic fit-out requirements, which make up about 60% of the total build-up cost when starting from a bare shell unit. M&E works include:
| M&E category | Description | % M&E cost |
|---|---|---|
| HVAC & Ventilation | Dedicated supply and exhaust systems with HEPA filtration, negative pressure zoning, make-up air capacity, and heat recovery systems. | 40–50% |
| Electrical & Data | Backup circuits, clean earth grounding, and dense data cabling for equipment. | 40–50% |
| Plumbing & Drainage | Acid-resistant drainage, dilution or decontamination sumps, purified water systems, emergency eyewash and shower stations. | 10% |
| Lab Casework & Benches | Chemical-resistant benches, mobile casework, and safety storage cabinets. | 10% |
| Fire Safety & Compliance | Ventilation interlocks, alarms, sprinkler modifications, chemical storage enclosures, in line with SCDF Fire Code and SS 641. | 5–10% |
| Finishes | Epoxy-coated floors/vinyl flooring, washable wall finishes, cleanable ceiling panels to support biosafety cleaning protocols. | 5% |
Beyond M&E and basic fit-outs, additional essential equipment and furniture make up a significant share of CapEx. Typical costs include:
- Core instruments: S$250k–350k for fridges, freezers, liquid nitrogen tanks, autoclaves, ovens and centrifuges
- Biosafety cabinets (BSCs): S$10–21k each (a 2,500 sq ft facility usually requires two to three)
- Fume hood: S$15–30k
- IT & Security: S$40k–60k for CCTV, card access, server racks and network infrastructure
- Emergency Power: S$2.2k–40k, depending on diesel generator rating for critical equipment such as fridges and freezers

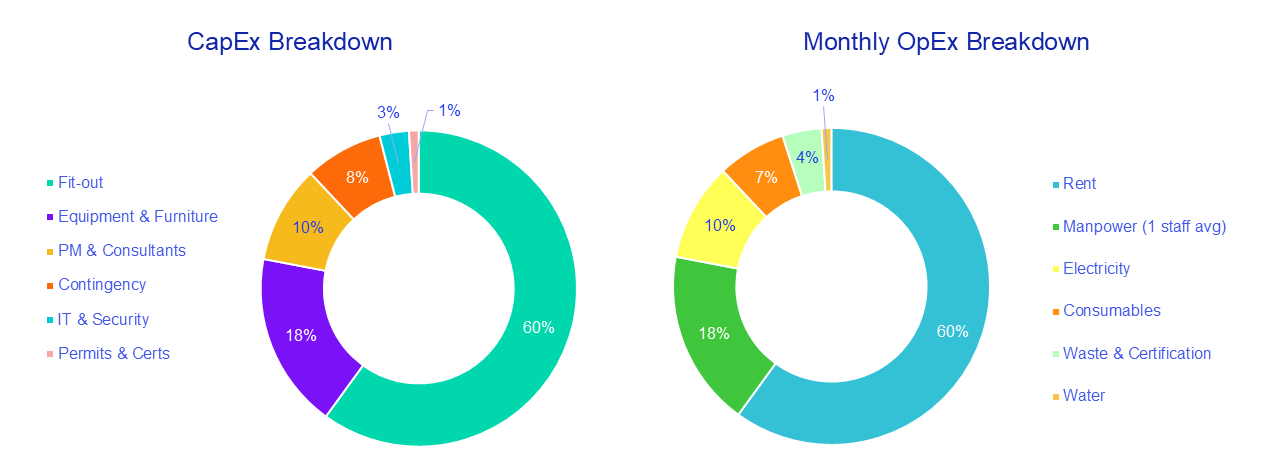

Lastly, professional services related to the build-out add further costs—typically 3–10% of construction for project management, 8–12% for design and QP consultancy, plus around S$20k for authority submissions and certifications (e.g. SCDF fire plan, BSL-2 certification). You’ll also need to factor in a 10–15% contingency buffer for any design changes or site condition rectifications during construction.
Operating Expenses (Opex): Month-to-Month Costs
Beyond rent, running a lab carries substantial ongoing expenses that recur every month.
| Category | Description | Cost |
|---|---|---|
| Electricity | Market dependent | S$0.27–0.29/kWh |
| Chilled Water | If district cooling is used, chilled water is chargeable | S$0.40–0.60/RTON |
| Water |
|
|
| Equipment Maintenance | Depending on complexity of equipment (e.g. ACMV; BSC/fume hood certs S$1.5–2.5k/year) | Onwards of S$10k/year |
| Services | Daily cleaning, licensed waste disposal | Onwards of S$2k/month |
| Consumables | Gloves, first aid kits, bio-hazard bags, paper towels, etc | Onwards of S$2k/mont |
| Manpower |
|
|
The Hidden Costs: Compliance and Licensing
Beyond
CapEx and OpEx, regulatory compliance is a non-negotiable part of
running a lab. These expenses may be less visible, but they are
essential for operating a BSL-2 lab safely and legally.
Key regulatory requirements for operating a typical BSL2 lab:
- SCDF Fire Code + SS 641: Labs that use chemicals must comply with fire safety and ventilation standards. SCDF Petroleum and Flammable materials licenses require both fees and ongoing administrative upkeep.
- PUB Trade Effluent Approval: Any lab discharging wastewater must secure approval, and discharges must be monitored regularly, with associated sample testing costs.
- NEA Toxic Industrial Waste Collectors contracts: This is mandatory for biohazardous/chemical waste collection.
- Insurance:
Mandatory coverage includes the Work Injury Compensation Act (WICA),
public liability, and property/contents insurance. Notably, the Ministry
of Manpower (MOM) will be raising WICA limits from November 2025, which
will add to future costs.
Putting It All Together
Building a BSL-2 lab in Singapore involves a seven-figure upfront investment, ongoing five figure monthly overheads, and constant attention to regulatory compliance. The better you understand the associated costs, the greater your chances of sustainable growth.
For startups still in proof-of-concept or preclinical stages and not ready to take on this huge commitment, consider a shared or co-working lab space as a more practical starting point.
Here at Node 1, our team is motivated to help companies figure out the right solution for their space needs, even if Node 1 is not the best fit for your stage of growth. If you need more information or support in planning your lab space, reach out to our Infrastructure team now!
